Geothermal Well Drilling Initiative – Construction Update – 5/31/19

During the week of May 31st

Park Test Well #3

  • The drilling subcontractor has completely flushed out debris from the borehole and was able to drop a probe to the bottom at a depth of 1500 feet. Construction crew is installing the high-performance geothermal piping within the borehole. Outer piping is anticipated to be compete by 5/31.
  • The construction manager has directed the subcontractor to begin installing the inner tubing and temporary well head on Monday, 6/3.
  • Pending availability of the testing agent, the construction manager intends to begin continuous 48 -hour conductivity testing to confirm the thermal performance of the TW#3.

Alley

  • No work is scheduled for the alley way.

As a reminder to all, please be aware of all directional signage, as pedestrian travel paths may be altered. Your safety is imperative!

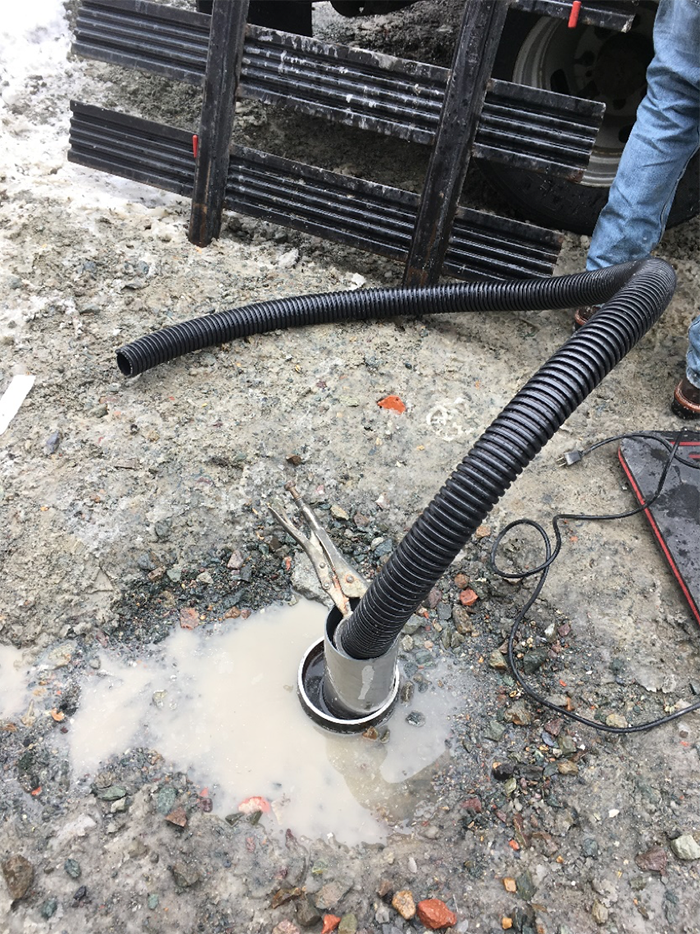

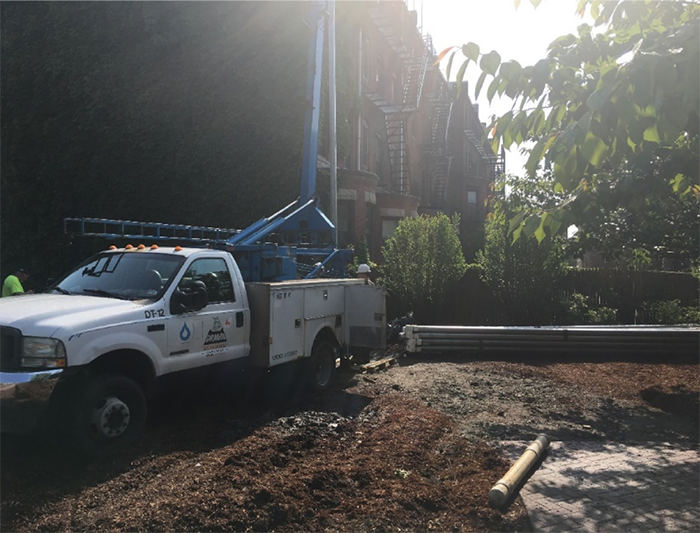

High Performance Geothermal Exchange outer piping installation
High performance geothermal exchange outer piping installation
High Performance Geothermal Exchange outer piping installation
High performance geothermal exchange outer piping installation



View all posts
